Scaffold access and handover tags — access as a scheduled resource

Why access is a resource with dates rather than a condition of the site, what a scaffold tag actually certifies and what it does not permit, why an untagged scaffold is a red one, and the load class that stacking materials quietly exceeds.

BeginnerOil & GasPetrochemicalInfrastructure & Buildings

Standards referencedEN 12811-1

Access is the resource that decides a piping sequence more often than crane time, welder numbers or materials, and it is the one most often left out of the plan — because it does not feel like a resource. It feels like a property of the place.

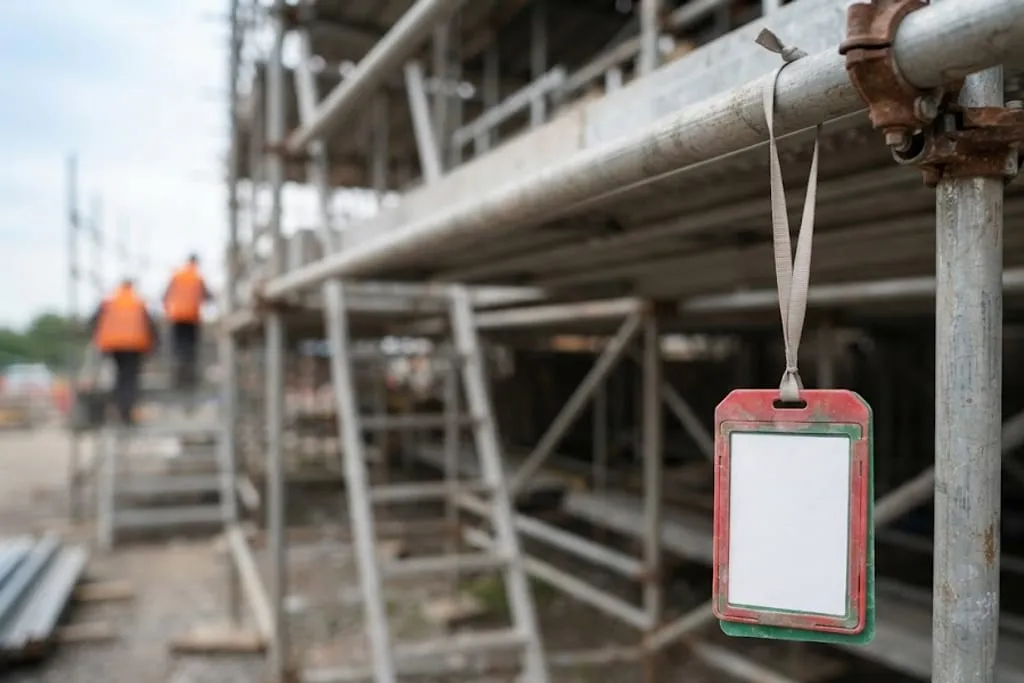

A scaffold tag holder in a red and green plastic sleeve hanging on a lanyard from a horizontal scaffold tube at the access point, the card inside it blank, with the ladder access and boarded lifts of the scaffold receding out of focus behind it.
The card is blank. Everything this topic is about is the difference between that and a completed one.

It is not. A scaffold is hired, erected, inspected, handed over, occupied, altered, re-inspected and struck. Every one of those is a date, and the dates belong to a different contractor with a different programme and somebody else’s priorities.

Access on the look-ahead

The habit worth building is to put access on the three-week look-ahead as a line of its own, alongside labour and materials. Three questions for each front of work:

Question Why
Does the access exist yet? If not, it has a lead time and a request that must already be in
How long is it needed? Scaffold left standing is cost; scaffold struck early is a crew standing idle
Who else wants it? Insulation, painting and electrical want the same platforms, usually later

The third is the one that bites, because the other trades’ need for your scaffold arrives after you have finished with it and after somebody has booked it to be struck.

What a tag actually certifies

A scaffold tag is a handover certificate. It records that a competent person inspected this structure, in this configuration, on this date, and that it is fit for a stated duty.

Three scaffold tag states. A complete tag means erected, inspected and handed over, and states the inspection date, the inspector and the load class. An incomplete tag means under construction or alteration and is for scaffolders only. No tag at all is treated exactly as an incomplete tag, because an absent tag proves nothing.
Green, red, and the third case people get wrong. An absent tag is not a permission — it is an absence of information.

The third case is the one that causes trouble. A scaffold with no tag is frequently read as “probably fine, nobody has got round to tagging it”. It may equally be a scaffold that was never finished, or one that somebody is part way through striking. The tag is the only thing that distinguishes those, and when it is missing the distinction is unavailable.

What a complete tag does not give you

Three things, and all three get assumed.

It does not permit exceeding the load class. The class is a design duty — people, tools and a defined quantity of materials. A platform used as a staging area for fittings, bundled small bore and drums of consumables will reach its class long before it looks crowded, because materials are heavy and nobody is counting them.

It does not permit alteration. Removing one board to pass a spool through, or slackening a tie for clearance, voids the handover. What was certified no longer exists. Only a scaffolder may alter a scaffold, and only a re-inspection restores the tag.

Requesting access well

A scaffold request that says “access to line 6 inch P-1502” will produce something, and it will frequently be the wrong thing. A request that gets what is needed states four things:

  1. What work is being done from it — welding needs different space and different protection from bolting
  2. Where exactly, including the height of the working position rather than the height of the pipe
  3. For how long, so that it can be programmed and struck
  4. What has to pass through or under it, which is what prevents the alteration that voids the tag on day one

The fourth is the one experienced supervisors add and everybody else learns to add. A scaffold that boxes in the route a spool has to travel is a scaffold that will be altered before it is used.

Check your understanding

6 questions. Nothing is recorded — this is just for you.

1A scaffold on site carries no tag at all. How should it be treated?
2What does the load class on a scaffold tag describe?
3A crew removes one scaffold board to pass a spool through, and replaces it afterwards. What is the status of the scaffold in between?
4Why should access be treated as a scheduled resource rather than a site condition?
5What is the most common way an access scaffold gets overloaded on a piping job?
6Why must an access scaffold never be used to support pipework, even temporarily?

#piping#construction#access#scaffold#supervision#planning
